Objective
To describe the different ways you can update the line items on a bill of quantities on a main contract.
Things to Consider
- Required User Permissions:
- Prerequisites:
- If you are using a Procore App Marketplace integration:
- Additional Information:
Steps
There are several ways to add and update line items on a main contract's BOQ:
Add Line Items to the Main Contract BOQ
- Navigate to the project's Main Contracts tool.
- Locate the main contract with the BOQ to update.
- Click Edit.
- Click Bill of Quantities.
- Click Add Line.
- Complete the data entry as follows:
- Budget Code
Select a budget code from the or click Create Budget Code to create a new one. See What is a budget code?
- Description
Enter a description for the line item. For example, type: Monthly Service Fee
- Qty
Enter in the quantity of units.
- UOM
Select the Unit of Measure (UOM) from the list. See Which units of measure (UOM) are included on Procore's master list? and Add a Unit of Measure to the Unit of Measure Master List.
- Unit Cost
Enter the Unit Cost in the box provided.
- Amount
The system automatically calculates the subtotal for you, based on the Qty, UOM, and Unit Cost entries.
- Repeat the above steps for all line items.
- Choose one of these options:
- Click Save
OR
- Click Save & Email.
Create a Main Contract BOQ from the Project's Budget
If you created a project budget (using the Budget tool), you can use it to quickly build out a Main Contract's BOQ. There are two options for how to create the Main Contract BOQ from the Budget tool. (Note: You can only perform this action if there are zero line items.)
- Navigate to the project's Main Contracts tool.
- Locate the main contract that you want to update in the list.
Note
To create a bill of quantities from a budget:
- The budget must be locked. See Lock a Budget.
- The main contract must be in the 'Draft' status.
- The BOQ must be blank (no line items can exist for the options below to be available).
- Click Edit.
- Click Bill of Quantities.
- Click Edit.

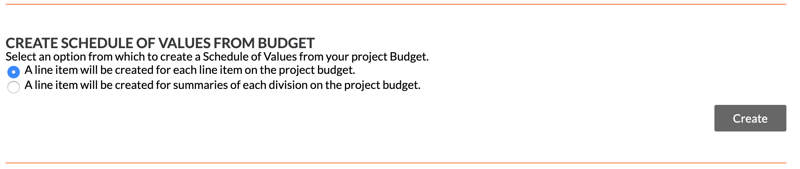

- Under Create Bill of Quantities from Budget, choose one of the available options:

- Option Button 1
This option creates one line item on the main contract's BOQ for each line item on the project's budget.
- Option Button 2
This option create one line item on the main contract's BOQ for the summaries of each division on the project's budget.
- Click Create.
Import a Main Contract BOQ from a CSV File
- Navigate to a project's Main Contracts tool.
- Locate the main contract where you want to import the BOQ.
- Click Edit.
- Click Bill of Quantities.
- (Optional) Under Import Bill of Quantities from CSV, download one of the template options:
- Blank Template
To download a blank template, click A Blank Template.
OR
- Template with Existing Line Items
To download a template that includes any existing BOQ line items, click One Showing Existing Line Items.
This downloads a template named 'csv_import.csv' to the location on your computer specified in your web browser's settings.
Notes:
- Using your own template or modifying a file to match a template can result in an incompatible format which can lead to import failure and/or import errors.
- After completing your BOQ data entry in a template, continue with the import process.
- While using a Procore template is marked (Optional), we recommend that you always download one of these templates to complete your BOQ data entry.
- If the combination of the sub job, cost code and cost type are non-budgeted for a line item, this line item will be added directly to the Budget with a "?" next to the line item. See Add a Partial Budget Line Item.
- Update the template with your BOQ line items.
Notes:
- Do NOT add, rearrange, remove or rename any of the columns or column headings in the template.
- To complete the import successfully, your data needs to be entered using the exact structure specified in the template.
- The cost code and cost type entries must exactly match the codes and types defined under Cost Codes in the project's Admin tool. See Add and Edit Project Cost Codes.

- Complete the data entry as follows:
- Cost Code Name
The detailed name of the cost code number in the following format:
'Division-Code - Title' (e.g. 01-100 - Summary)
Note: if you do not want to use a cost code, you must enter "None" in the Cost Code Name and Cost Code Number fields.
- Cost Code Number
The cost code number in the following format:
'Division-Code' (e.g. 01-100)
Note: if you do not want to use a cost code, you must enter "None" in the Cost Code Name and Cost Code Number fields.
- Description
(Optional) A more detailed description of the line item.
- Line Item Type
(Optional) The cost type associated with your cost code (e.g., Labour, Materials, etc.). See Default Cost Type List.
Notes:
- You can modify the default cost types and add its own definitions to the list.
- It is important that your data entries match your company's cost type list. For example, if the category type is Materials, use M and not m, materials, or Materials. Below are the Procore's default Cost Types. Invalid entries are listed as Other in the Type column.
- The import process is case-sensitive.
- Amount: Enter a numeric value or the contract amount. (The use of commas and/or the pound symbol (£) are not required.) For example, '15000' is correct syntax. If there is no sterling amount to enter, be sure to enter 0.00 (the import will not accept a blank cell).
Note: Blank lines still count as lines in the import process, so be sure to delete them from the end of the BOQ file before importing.
- Specify the type of import/upload action to perform.
- Delete existing line items and add CSV as new items
- Keep existing line items and add CSV as new items
- Select the modified CSV file.
- Click Import.
- Wait a few seconds and then click the Bill of Quantities tab.
- Verify that the BOQ was imported as expected.

- If you need to make further changes to the BOQ, click Edit.
- Manually add additional line items
- Delete a line item
- Change the selected cost code number
- Edit a line item's description, type and contract amount
- Click Save.
OR
Click Save and Email if you want to save your changes, as well as forward a copy of the Main Contract using Procore's built-in email feature. You'll also be able to specify recipients and include a brief message about the Main Contract.
